Small kitchen extension and new kitchen started at the very start of September. Work was scheduled in in May. I told him I didn't want to start until he could guarantee a solid run of trades in. He said he understood. He said he has done enough of our type of house (modern estate) to not foresee any problems. He said it would take 2 months and quoted us 17k. He said this did not include electrics, plumbing, painting or worktops or kitchen/appliances. Is a very small extension - probably the size of three normal sized downstairs loos but we needed to do it to get a solid run of wall without windows/doors.
He suggested we build the new kitchen (as it is going in the new end) before the old one is removed, so that we wouldn't be kitchenless.
This guy is a neighbour and whilst I wouldn't say a friend (not now!) we have socialised together with others in our road.
It's been a catalogue of errors and delays. Mainly because he has also had two big jobs running at the same time. An example of things that have happened:-
- Four weeks in there was a miscommunication between this PM (runs his old building company, fingers in lots of different pies), the plumber and roofer which resulted in us not being allowed to use our boiler for 5 days over a weekend (so no heating or hot water).
- Six weeks in the roof still wasn't watertight and flash floods took out all our electrics on a Sunday. We were without for about 4 hours. It actually took 2 months for them to knock through.
- A couple of months in he said we'd need to factor in 1k to pay the kitchen fitter and some money for labour to remove the old kitchen. We thought this was part of the lump sum work (because why wouldn't it be + he told us what WASN'T included). I think he has actually incurred more costs because of running over, and so wants to recoup that from us.
- This week the plasterer plasterboarded the old kitchen ceiling as instructed by PM. But the electrician had not finished up there. Now electrician cannot get back until next week sometime. And plasterboard needs to come down again (I know and trust electrician and believe cock up is PM's).

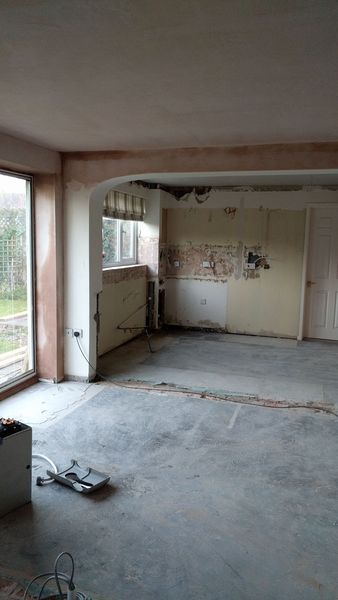

- Two days ago the old kitchen was taken out despite the new part just being a plastered, empty shell. I have nothing. Not even a tap.
- Today whilst I happened to be in the back garden I saw that he had put our 1k water softener in the back garden TWO DAYS AGO, next to the oven and dishwasher which I have paid the council to take away. A) he didn't empty it so the water in it is frozen (which could crack it on thawing and B) the council would have taken it away had I not realised.
Over the last 13 weeks we have probably had a whole month where we've had no-one on site. This is the reason it has run over.
I have two boys, 13 and 11. I have no facilities. Had I known I would have made plans, but HE told me we wouldn't be without a kitchen. DH travels a fair bit atm and is in the US for 6 days.
Every week something slips. Units were meant to be built this week. Granite templating was meant to happen today (it didn't). Granite takes 7 days to arrive and the units are still in their individual parts, taking up all the space in my dining room. Not even built so templating not gonna happen any time soon. It's the 1st of December ffs.
And to top it all off I saw a mutual friend last week who told me he has been complaining to ex-neighbours that WE are being unreasonable (because I am asking for weekly updates and want to know what is going on and what is being done about issues. All friendly so far as I haven't wanted things to get awkward..
So, today I kind of let him have it. I feel like cumulative stress/disappointment/bullshit/poor expectation management and communication/extra finances has finally caught up with me. DH says I need to calm down, although he is equally pissed off but handles it better or rather differently (but he's not here is he!).
Never had such a big building project done before. Is this normal and AIBU to be really effing pissed off?
